Elevate Composite Structures
Diamond™ / Raised-floor reinforcement

ECS-DD100 · Patent pending

Reinforcement beneath your existing floor.

Add support where heavier equipment demands it. Diamond works with the existing raised-access floor to support targeted AI, GPU, and liquid-cooled deployments.

Diamond composite pedestal supporting an existing raised-floor grid

Composite structure. Steel interfaces. Support added beneath the existing floor.

~45 minutes

Typical installation per support; access and site conditions vary.

Targeted placement

Review rack positions, equipment zones, and transportation routes.

Project-specific

Compatibility, anchorage, and allowable loads established by engineering review.

The retrofit challenge

The next rack can change what your floor needs.

Heavier equipment changes the concentrated loads on the existing floor panels and stringers. Operators need a way to review and reinforce those locations without rebuilding the entire understructure.

Start with the floor you already have.

Diamond adds support beneath selected areas. The existing system and proposed equipment determine the final reinforcement layout.

How the system works

Follow the support beneath the equipment.

01

Existing stringers

Additional support at the midspans reduces the unsupported stringer length.

02

Paired beams and support pad

Reinforcement beams and the pad add support beneath the floor panel.

03

Diamond pedestal

Four individually adjusted columns carry the reinforcement assembly down to the slab.

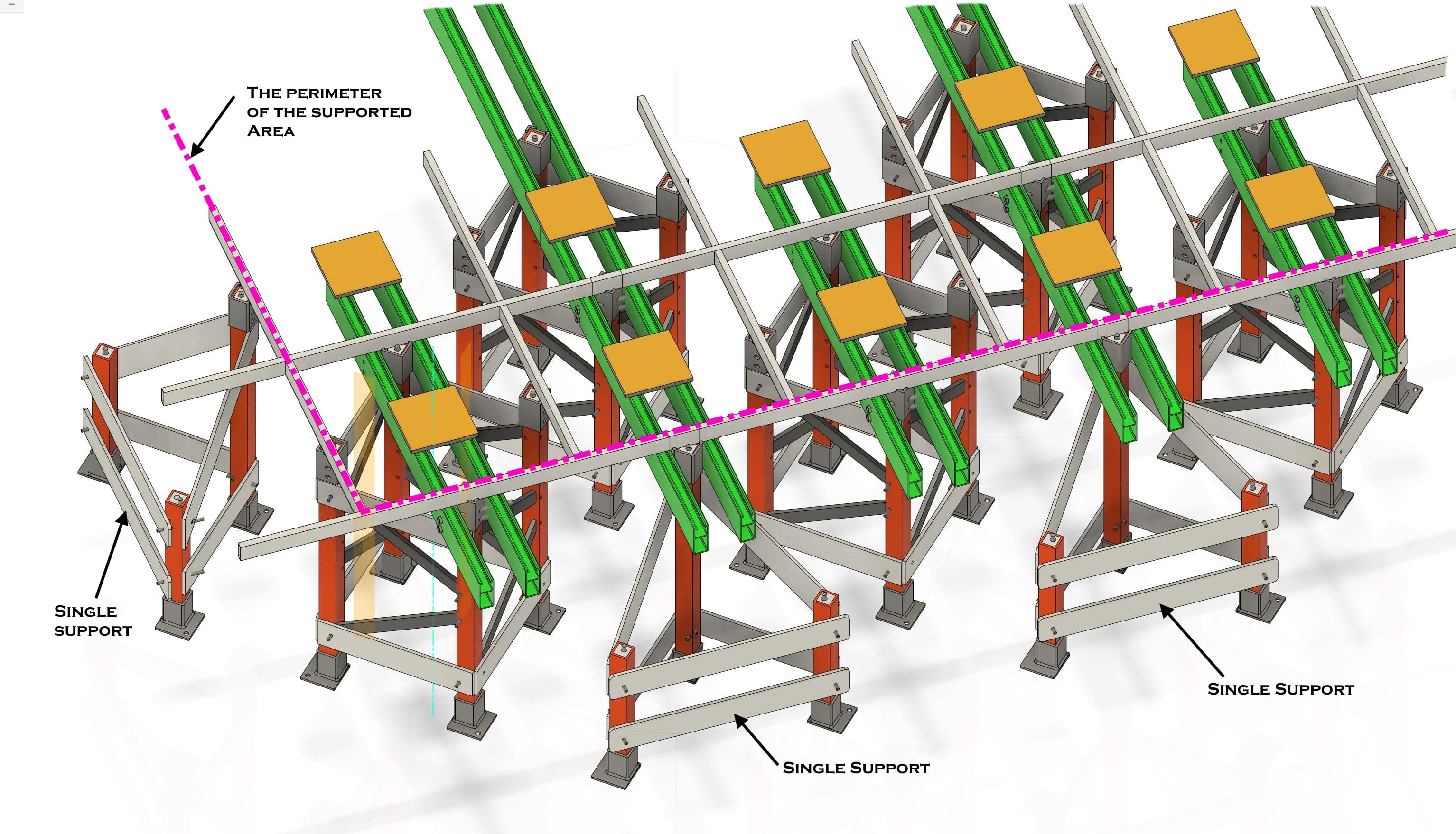

Diamond pedestal positions within the existing raised-floor grid

Example support layout. Final placement is determined for the project.

Installation Sequence

How the Diamond system installs.

Reinforce an existing raised-access floor without replacing the entire understructure. Stands are shipped flat-packed and can be assembled around existing underfloor obstructions. Custom-engineered support configurations provide floor reinforcement where utilities or other obstructions prevent standard stand placement.

The animation shows the standard assembly. Step through the sequence below, or press play to watch the installation.

Start with your floor

A configuration for your facility.

Floor height, stringer geometry, equipment loads, and site requirements determine the right reinforcement. We review your existing system before recommending a configuration.

Share your floor information →
01

Existing system

Manufacturer, grid module, floor height, and stringer profile.

02

Planned equipment

Rack footprint, populated weight, layout, and transportation route.

03

Site requirements

Slab conditions, anchorage, seismic criteria, and operating procedures.

Detailed compatibility checklist

Floor manufacturer

Tate, Kingspan, Haworth, Raised Floor Solutions, and others, grid geometry and stringer profiles vary by manufacturer.

Grid module

Standard 24″ × 24″ grid, 600 mm metric modules, and non-standard configurations.

Floor height

Underfloor clearance affects column length, adjustability range, and lateral performance.

Stringer profile

Roll-formed, extruded, and structural stringer sections each present different bearing conditions.

Pedestal configuration

Head geometry, existing load ratings, and anchor conditions at the slab.

Slab condition

Concrete flatness, existing penetrations, slab thickness, and anchor capacity.

Existing floor rating

Concentrated load and uniform load ratings from the current understructure documentation.

Target rack weight

Populated rack weight including servers, power distribution, and rear-door cooling.

Seismic criteria

Site S₝ₛ value, facility risk category, and applicable code jurisdiction.

Performance

Performance for the evaluated configuration.

Equipment loads, tile limits, and column analysis loads describe different parts of the system. These published analysis figures apply to the standard evaluated configuration; project-specific review establishes final allowable loads.

Up to 5,744 lb
Supported equipment load
For the standard evaluated floor configuration — see Design Basis below.
5,000 lb
Individual column analysis load
Twice the maximum load any single column sees in normal use.
4,800 lb
Code-factored tile load limit
Code-factored limit for the evaluated floor configuration.
28%
Remaining peak stringer bending moment
Compared to the same stringer without Diamond installed.
~25,000 in-lb
Overturning resistance
Per support, at design seismic force.
~45 min
Typical installation time
Per support, one installer.
8 sq ft
Floor area influenced per support

Approximate, per installed unit.

Final allowable equipment loads depend on the existing raised-floor system, rack footprint, site conditions, seismic requirements, and project-specific engineering review. Values shown reflect the standard configuration analyzed in the design basis; they are not project-specific design criteria.

Engineering and Technical Details

Design basis and technical detail.

Applications

Where Diamond fits.

Rack loads

AI / GPU Rack Rows

Support heavier high-density compute infrastructure. Reinforce specific rack lanes for AI, GPU, and accelerator deployments without rebuilding the surrounding floor.

Cooling equipment

Liquid-Cooled Deployments

Support racks, coolant distribution units (CDUs), rear-door heat exchangers, and related high-density equipment that adds combined structural loading.

Moving loads

Equipment Transportation Paths

Create reinforced routes for moving or positioning heavy equipment through active data halls with moving-load requirements reviewed for the existing raised-floor system.

Phased upgrades

High-Density Retrofit Zones

Upgrade selected areas of existing colocation, enterprise, HPC, and hyperscale data halls for heavier infrastructure requirements.

FAQ

Common questions.

Don't see your question? Contact us directly at info@elevate-cs.com.
